LiNotes Prevux LiBoard LiCida LiCal LiDio DEENFR
Example project · Automotive · ISO 26262 · Automotive SPICE

An ASIL D project.
From HARA to release.

An electromechanical brake for the rear axle – ASIL D, split into a main controller ASIL C(D) and a safety monitor ASIL A(D). This is how you set up such a project in LiNotes, steer it with your team and supplier, and bring it to completion with seamless reporting.

Board “EMB System – requirements and changes” with the columns CR, Analysis, Implementation, Verification and Released

All names, requirements, figures and results are made up. The pictures show the real LiNotes app with this sample data.

4
development boards: system, MCU A, MCU B, bug reports
7
project folders along the safety lifecycle
6
roles – from safety manager to supplier
SHA-256
for every piece of evidence in the report

1 · Set up

The project structure is
the safety lifecycle.

One folder for the item, subfolders for each phase and each element. Inside, notes, boards, plans and checklists sit side by side – like project files, only searchable and end-to-end encrypted.

Folders by phase and element.

  • 01 Safety plan and concept – safety plan, item definition, HARA, functional safety concept (ISO 26262-2, -3).
  • 02 System – technical safety concept and the system board (ISO 26262-4).
  • 03 Main controller – ASIL C(D) and 04 Safety monitor – ASIL A(D) – a board of its own for each decomposed element (ISO 26262-5, -6, -9).
  • 05 Problem resolution – bug reports from testing and the field.
  • 06 Release and safety case – confirmation measures, minutes, safety case.

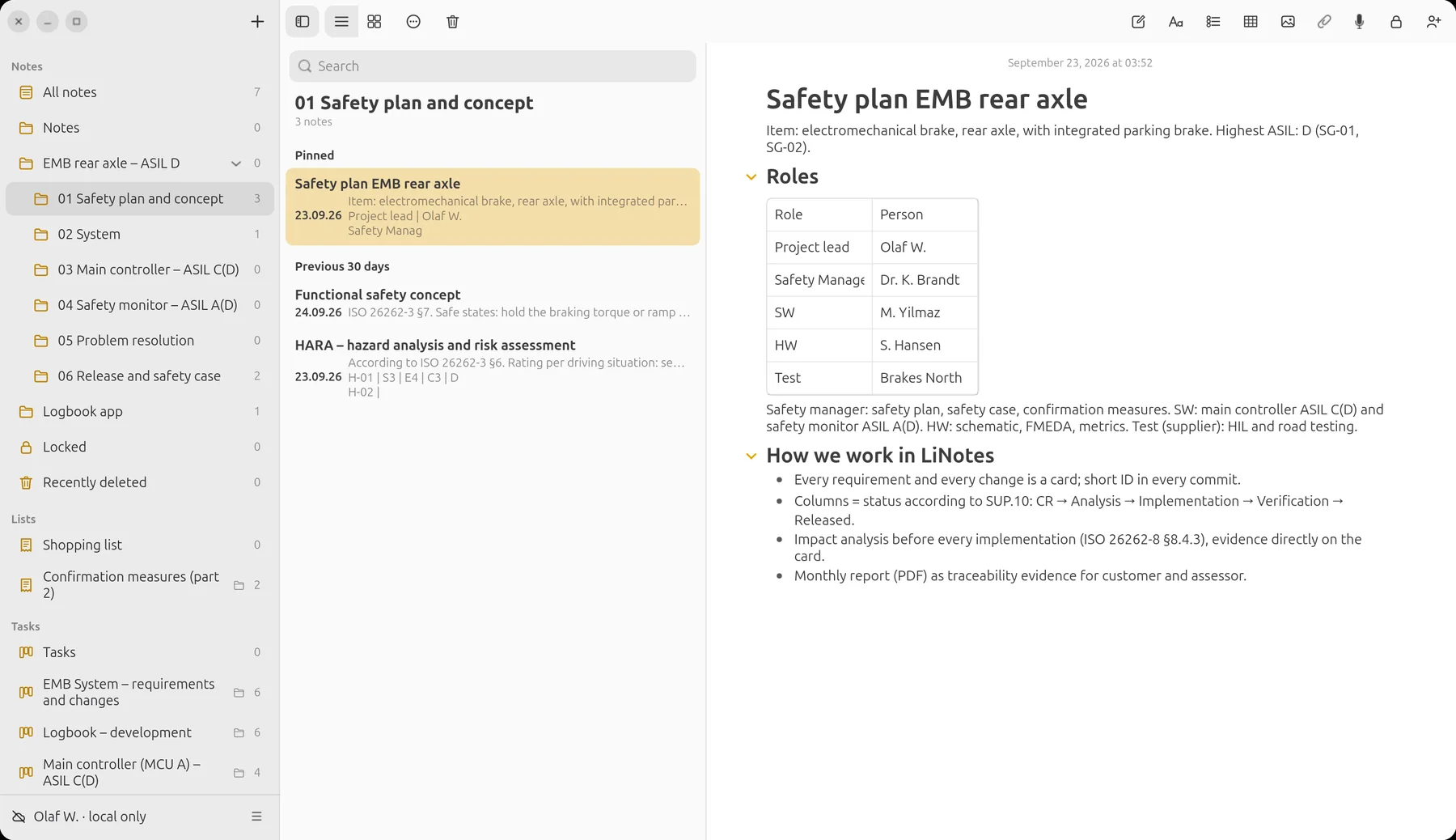

Safety plan in folder 01 with role table and way of working

HARA and safety goals.

Hazards with severity, exposure and controllability as a table, below them the safety goals SG-01 to SG-03. Every requirement created later names “its” safety goal – so the common thread stays visible.

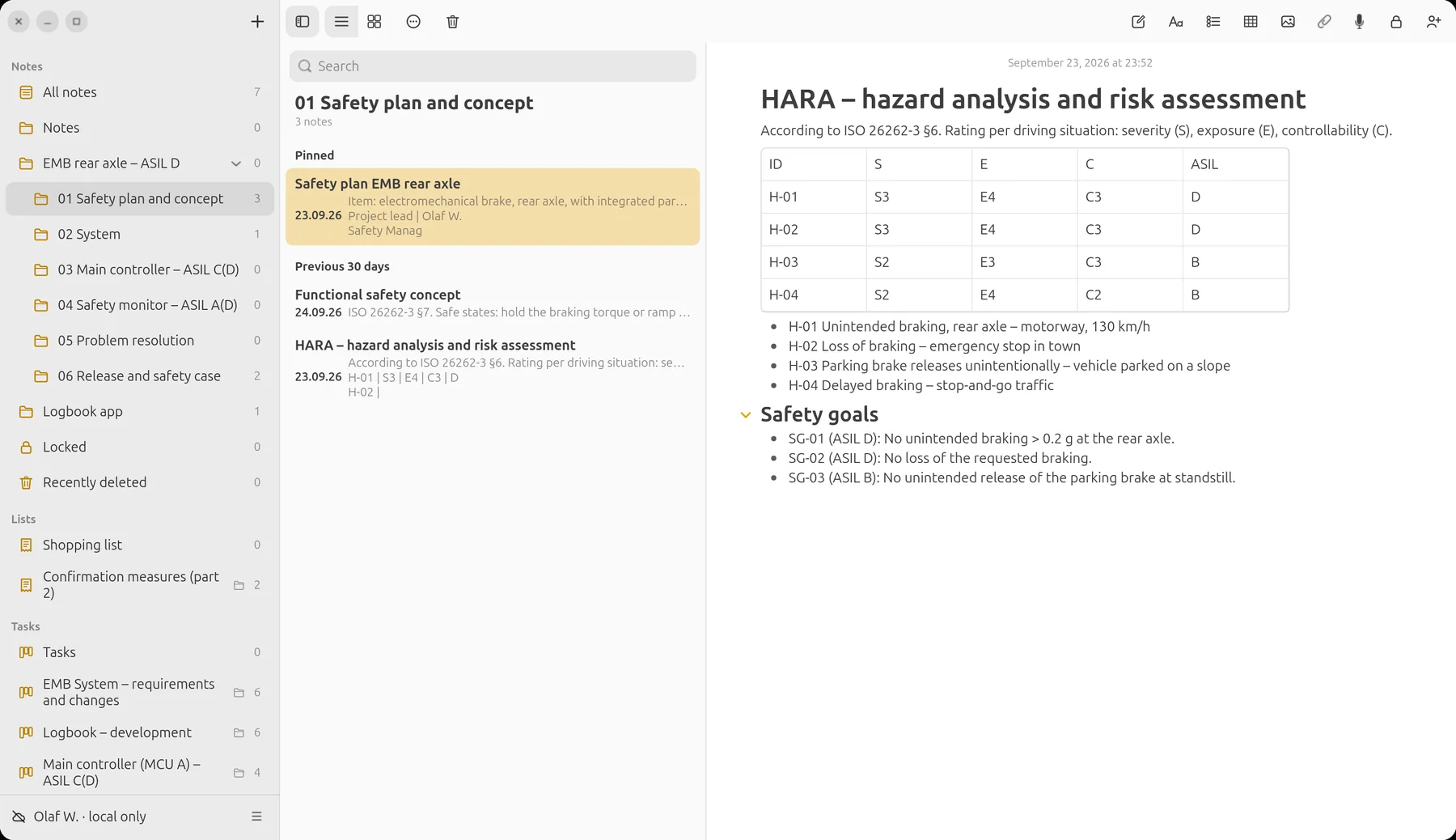

HARA note with S/E/C/ASIL table and safety goals

ASIL decomposition:
D = C(D) + A(D).

The technical safety concept splits SG-01 according to ISO 26262-9 across two independent elements: the main controller (MCU A) with ASIL C(D) and the safety monitor (MCU B) with ASIL A(D). The dependent failure analysis and the hardware metrics from the FMEDA sit right next to it.

  • Each element gets a board of its own – with its own team, its own status, its own report.
  • Independence is checked as part of every card’s impact analysis.

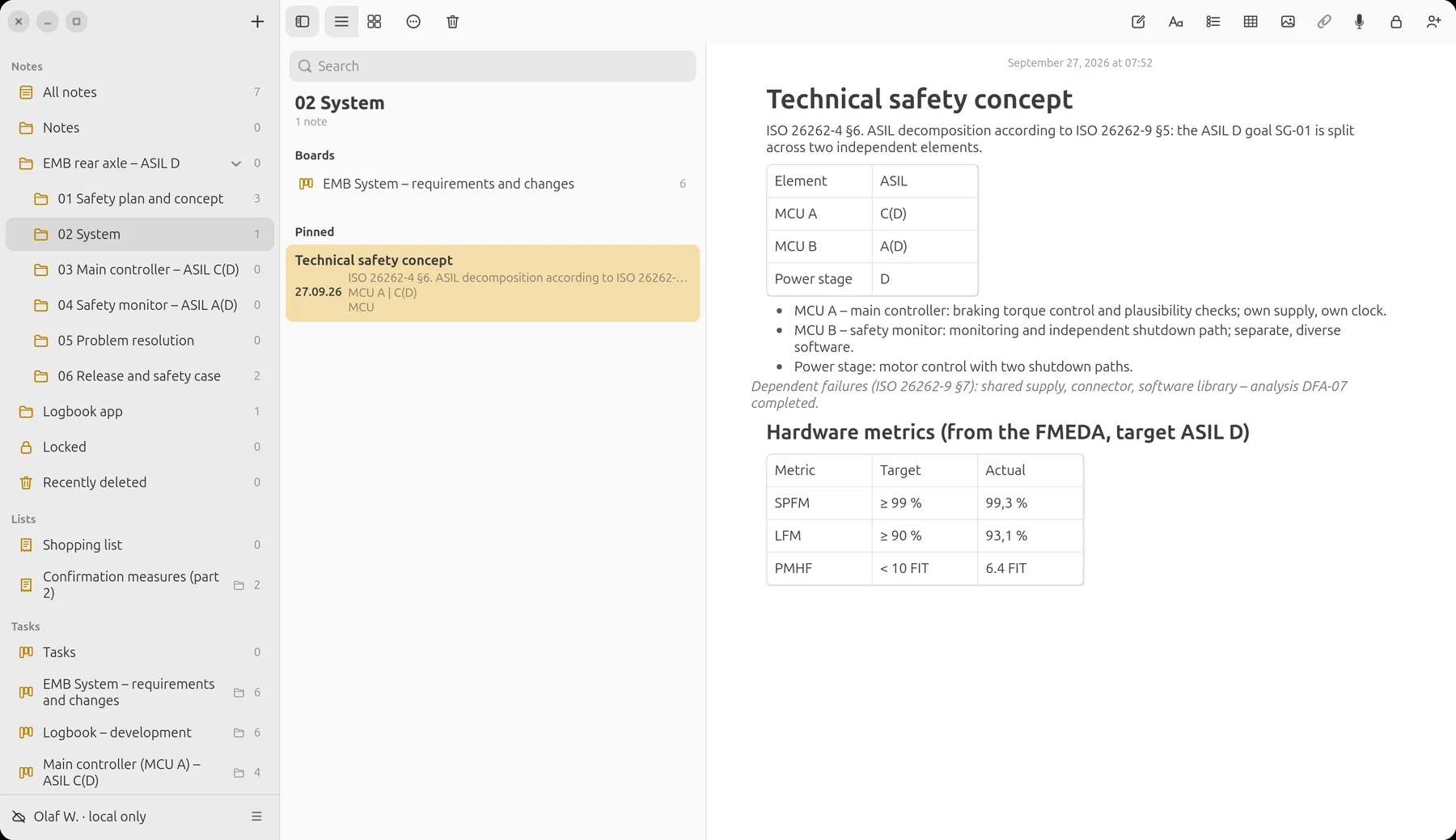

Technical safety concept with decomposition table and hardware metrics

2 · Steer

Every requirement, every change,
every bug – one card.

One click turns a board into a development project. Cards then carry a short ID, their status history and the fields for impact analysis, verification, version and commits.

Development board

System: system requirements (SysRS) and the customer’s change requests (CR). Columns = status according to SUP.10; acceptance into “Released” is done by the safety manager.

🧭

Impact analysis first

Before a card goes into implementation: which safety goal, which ASIL, which elements, what regression scope (ISO 26262-8 §8.4.3).

👥

Roles and responsibility

Safety manager, development, hardware, supplier: every card has a person responsible. With @-mentions you bring someone in specifically.

🤝

Involving the supplier

Boards can be shared individually with verified people – the supplier’s test bench sees exactly its own cards, end-to-end encrypted (DIA, ISO 26262-8 §5).

🔗

Commits automatically

If the card ID is in the commit message, LiNotes links the commit to the card – bidirectional traceability without manual work.

🕓

Status history

Who moved the card from “Analysis” to “Implementation”, and when? The history is on every card and in the report.

🏷️

Version

Every card names the state in which it is implemented (e.g. SW 2.3.0 / HW C2) – for configuration management and release.

The project plan
up to SOP.

Phases according to parts 3 to 6, B and C samples, confirmation reviews and the functional safety assessment as milestones. The red line is today – one look shows where the project stands.

Project plan as a timeline with phases, samples and milestones up to SOP

3 · Prove

The evidence is attached
to the requirement.

No reference to a report somewhere on a drive: test reports, measurement curves and screenshots are attached encrypted directly to the card – with time, person and checksum.

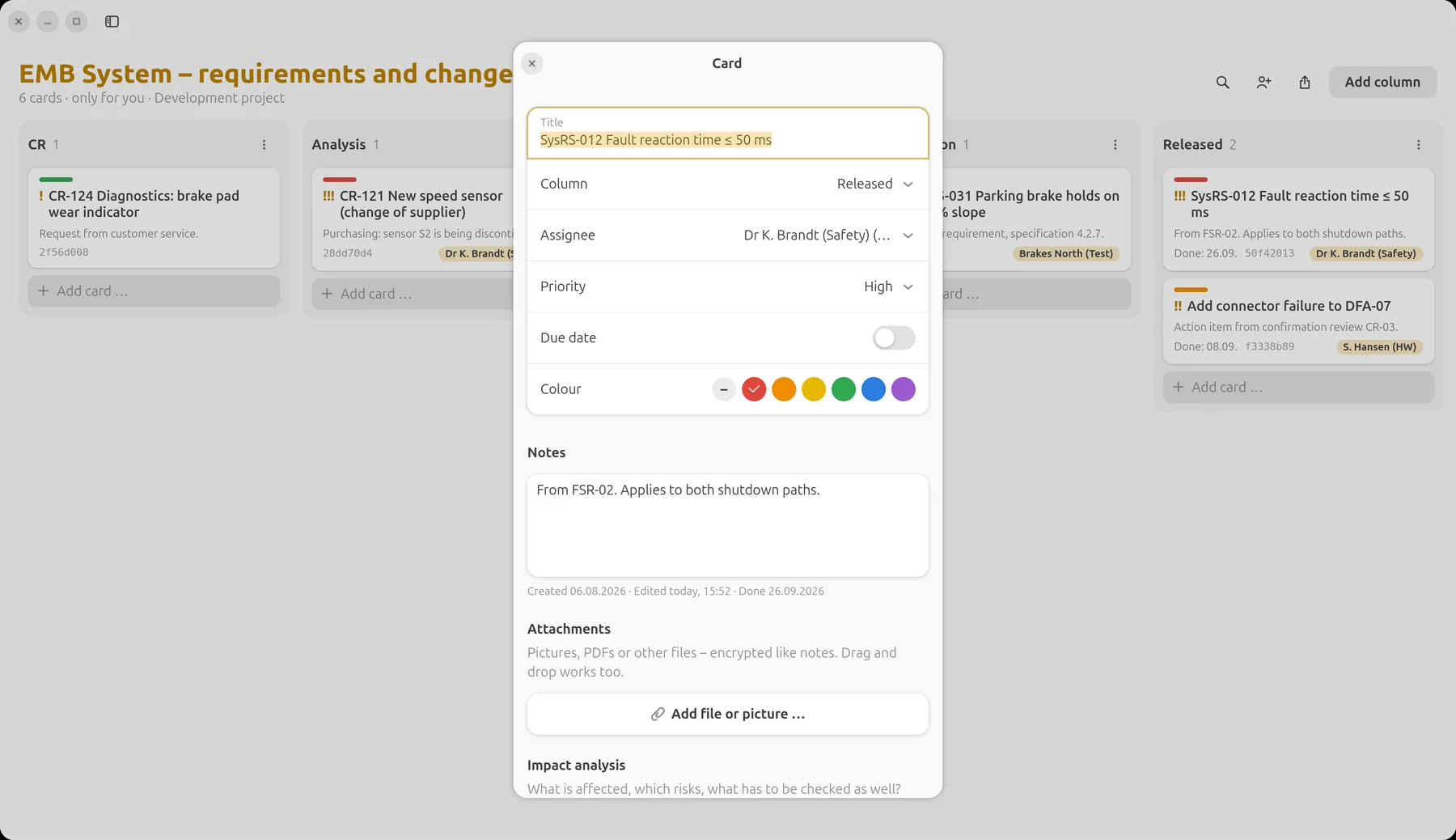

Card SysRS-012 with column, assignee, priority and notes

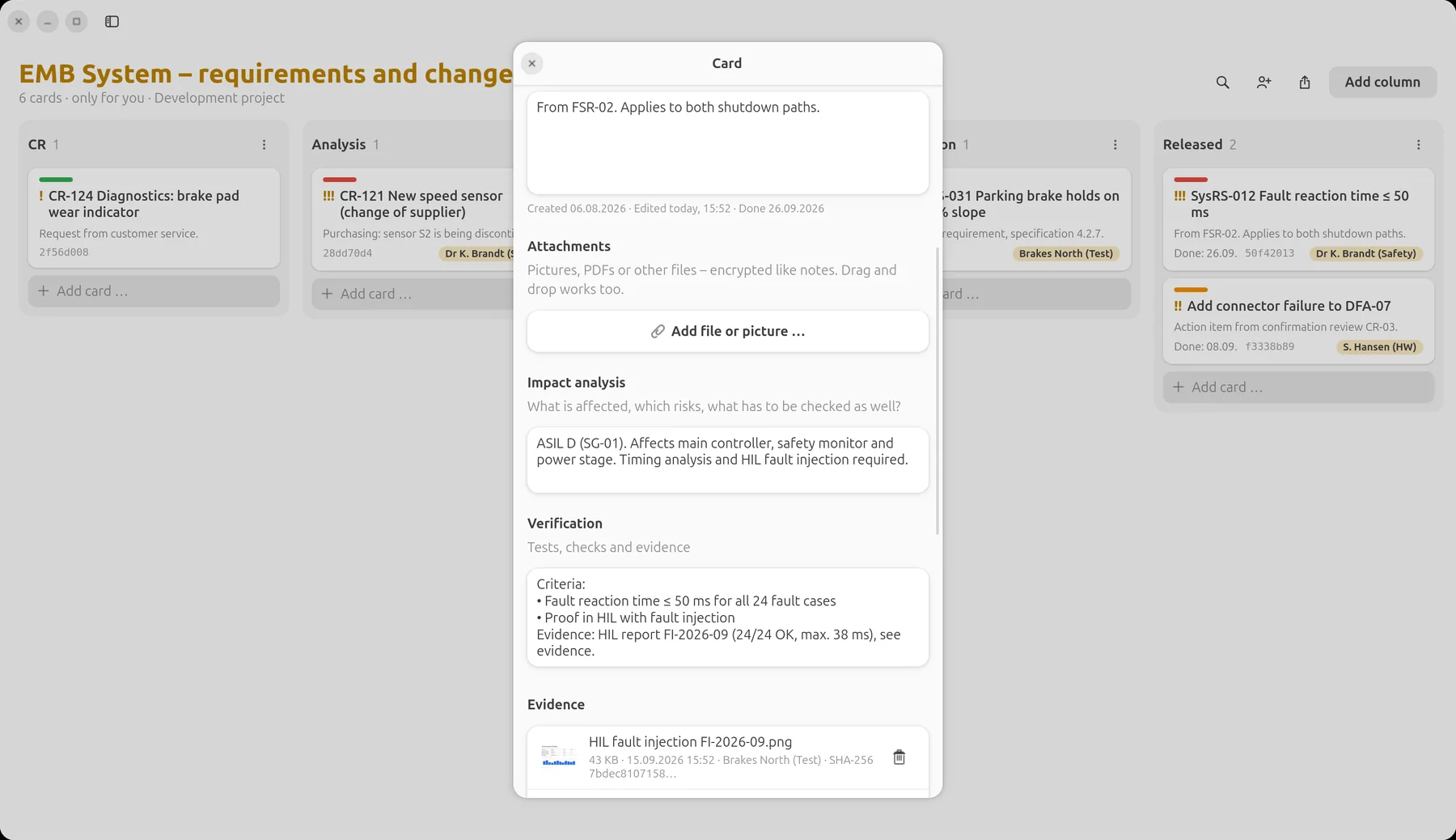

The same card: impact analysis, verification with criteria and the HIL fault-injection evidence

SysRS-012 “Fault reaction time ≤ 50 ms”: impact analysis across three elements, criteria and the HIL report with 24 fault cases as evidence.

Reporting
at the push of a button.

Right-click a board → “Export report”. Out comes a PDF with a traceability matrix and a detail page per card – description, impact analysis, verification, evidence with SHA-256 and embedded images, commits, history and acceptance. As CSV for further processing.

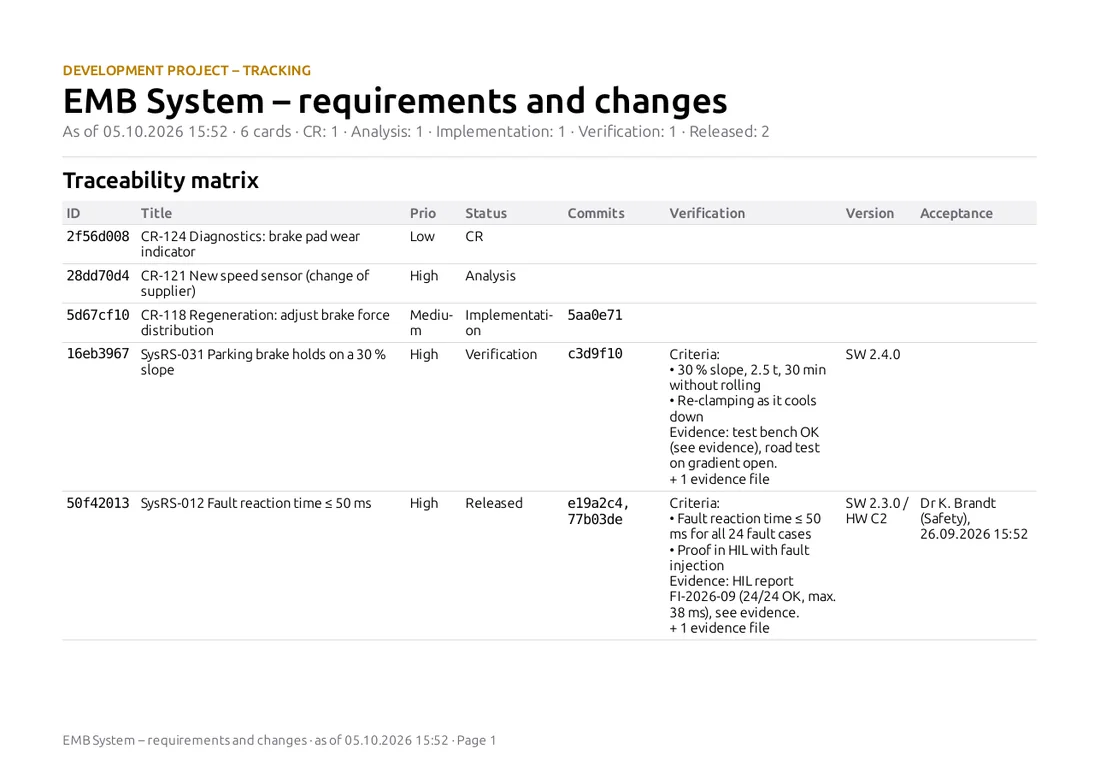

System board report: traceability matrix

Report: detail page with embedded HIL evidence and checksum
📅

On a schedule

Monthly per board to customer and assessor – one PDF per element, with the date in the file name.

🔏

Verifiable

The SHA-256 in the report proves which file was attached as evidence – even years later.

✅

Acceptance visible

Who moved a card to “Released”, and when, is shown in the matrix.

4 · Completion

Confirm,
assess, release.

The confirmation measures according to ISO 26262-2 – confirmation reviews, audit, assessment – run as a checklist with the degree of independence. The safety case collects the argument and refers to the boards’ reports.

  • Minutes of the reviews as a note, action items as cards on the respective board.
  • Release for series production once all cards are released and all confirmation measures are done.
  • Final report: the PDF reports of all boards plus the safety case – with checksums of all evidence.

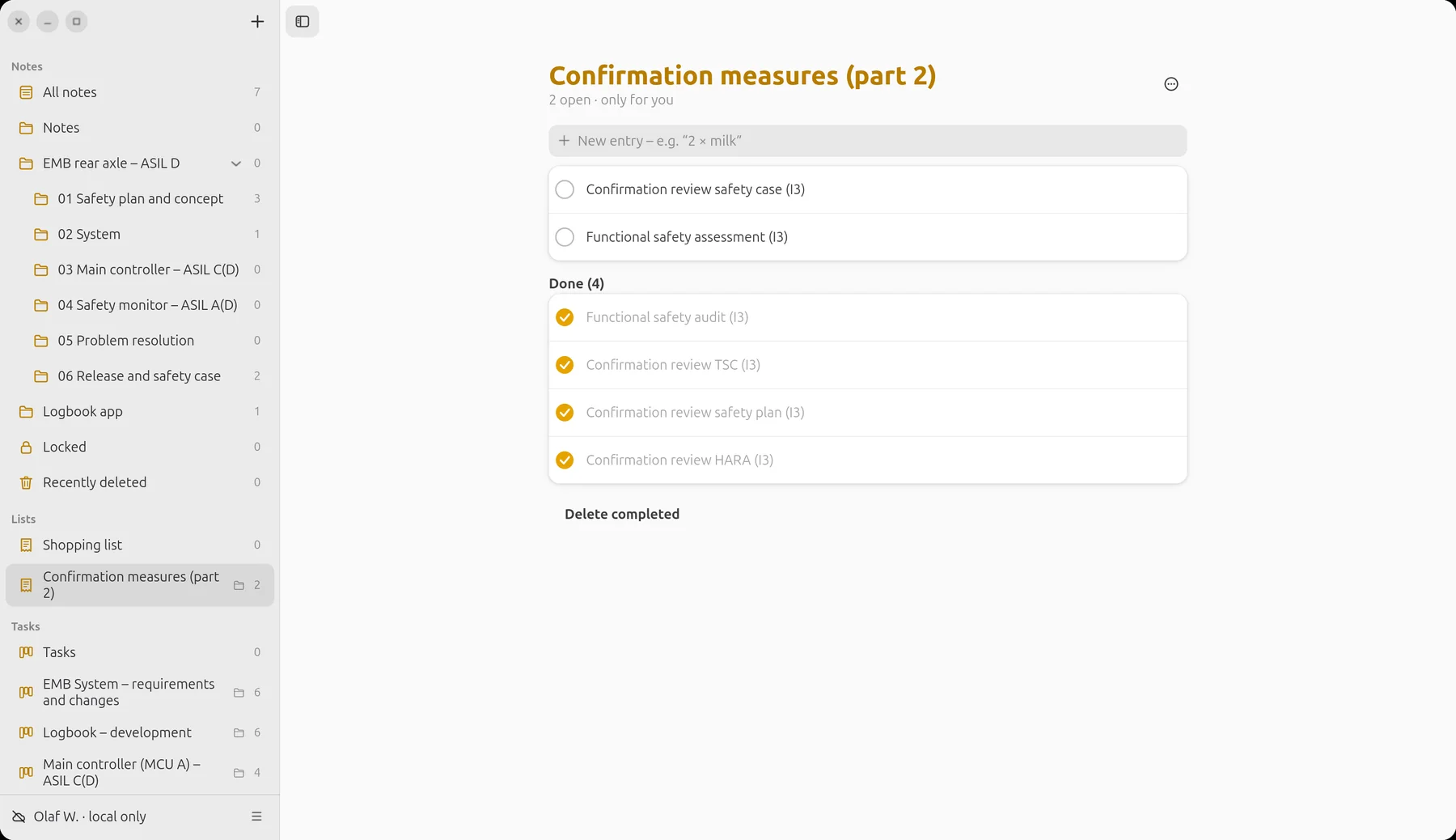

Confirmation measures list with open and completed reviews

Classification

What LiNotes covers
for ISO 26262.

Honestly put: LiNotes is a tool for organisation, change management, traceability and evidence. It does not do technical analyses such as FMEDA, FTA or timing analysis itself – it documents and links their results.

covered by the app’s featurespartly with limitsdocumented store and link resultsnot in focus
PartContentDegreeIn the example
Part 2Management of functional safetypartlySafety plan and roles as a note, confirmation measures as a checklist, safety case as a note with references to the reports.
Part 3Concept phasedocumentedItem definition, HARA with an S/E/C/ASIL table, safety goals and functional safety concept as notes.
Part 4Product development at the system levelpartlyTechnical safety concept, system requirements as cards with verification and HIL evidence; integration and test phases in the project plan.
Part 5Product development at the hardware leveldocumentedHardware metrics (SPFM, LFM, PMHF) from the FMEDA as a result; hardware changes as cards with impact analysis.
Part 6Product development at the software levelpartlySoftware requirements per element as cards, MC/DC report as evidence, commits linked. Static analysis and coverage measurement come from your tools.
Part 7Production, operation, servicenot in focusPossible: field monitoring as a bug report board.
Part 8 §5Distributed development (DIA)coveredShare boards specifically with the supplier, responsibilities on every card, end-to-end encrypted.
Part 8 §6Safety requirementspartlyUnique ID, status, assignment to safety goal and element, traceability to commits and evidence. No formal attributes or baselines as in a requirements tool.
Part 8 §7Configuration managementpartlyVersion on every card, linked commits, status history. The baselines and versions themselves live in Git or your CM system.
Part 8 §8Change managementcoveredCR workflow with columns, impact analysis, decision, implementation, verification, acceptance with person and time.
Part 8 §9VerificationcoveredCriteria per card, evidence with SHA-256, report with embedded test reports.
Part 8 §10DocumentationpartlyNotes, reports as PDF, everything encrypted and searchable. Notes have no version history – store released documents additionally as PDF evidence with a checksum.
Part 8 §11Confidence in the use of software toolsup to the userLiNotes is not a qualified tool. Tool classification (TI/TD → TCL) and qualification, if needed, are up to you.
Part 9ASIL-oriented analysesdocumentedASIL decomposition D → C(D) + A(D) and dependent failure analysis in the technical safety concept, one board per element.

Classification

And for
Automotive SPICE.

Names according to Automotive SPICE 3.1; in version 4.0 the processes are cut similarly. An assessment evaluates the way you work – LiNotes supplies the work products and evidence for it.

ProcessContentDegreeIn the example
SUP.10Change managementcoveredChange requests as cards, status through columns, impact analysis, decision, tracking through to acceptance, report.
SUP.9Problem resolution managementcovered“Bug reports” board: report, analysis, correction, verification, closure – with cause and evidence.
MAN.3Project managementcoveredProject plan with phases and milestones, responsibilities, priorities and due dates on cards, progress per column.
ACQ.4Supplier monitoringpartlyShared boards with the supplier, test evidence directly from them; contracts and assessments elsewhere.
SUP.8Configuration managementpartlyVersions and commits on the cards; baselines in the version control system.
SUP.1Quality assurancepartlyChecklists, review minutes, acceptance with person and time; escalation via cards.
SUP.4Joint reviewspartlyMinutes as a note, action items as cards with responsibility and evidence.
SYS.2–SYS.5System requirements through to system testpartlyBidirectional traceability requirement ↔ implementation (commits) ↔ test (evidence) per card; architecture and test specification in your tools.
SWE.1–SWE.6Software requirements through to software testpartlyAs above at element level (MCU A, MCU B), with MC/DC and unit test reports as evidence.
SUP.7DocumentationpartlyProject files in folders, reports as PDF; without a document release workflow.

This example is guidance, not standards or legal advice. Whether an approach passes an assessment is decided by your process, your evidence and the evaluation by independent assessors.

Try it yourself.

LiNotes is free, open source and runs on your own server – and locally without a server too.
